IT Roadmap for NZ Businesses: How to Build One

An IT roadmap turns business goals into a prioritised schedule of technology work. It shows what needs to change, why it matters, who owns it, what it may cost and which decisions must happen first.



This guide explains how to build and maintain one, with a worked example for a smaller NZ business and a template you can copy. It is written for owners and managers who want technology decisions planned around the business rather than made one problem at a time.

For help building or reviewing a roadmap, see our IT consulting service.

What is an IT roadmap?

An IT roadmap is a written plan that connects agreed business outcomes to sequenced, owned and costed technology initiatives. Each item says what will change, which business need it serves, who is accountable, what it depends on and when it will be reviewed.

Some businesses call the same document a technology roadmap. The label matters less than the content: a roadmap is useful when someone can read it and see what is committed, what is proposed and what has to be decided next.

How is an IT roadmap different from an IT strategy?

An IT strategy sets direction, priorities and the principles for technology decisions. The roadmap turns that direction into a schedule of initiatives with owners, dependencies and costs. Our guide to IT strategy covers the direction-setting work that comes first.

How is it different from an IT budget?

The budget funds the part of the roadmap due in the coming financial year. The roadmap explains why each item is there and what depends on it, so budget decisions can be tested against agreed priorities rather than whatever broke last. Our guide to IT budget planning covers the annual budget itself.

Where the main job is replacing ageing systems in a workable order, our guide to IT modernisation goes into that sequence in more detail.

What can an IT roadmap do, and what can it not do?

A roadmap makes known technology work visible early, so it can be funded, scheduled and discussed before it becomes urgent.

  • It can anticipate known events. Record contract renewals, planned projects and announced licence or vendor support changes as dated items. Note the source and review date, because supplier plans can change.
  • It can show dependencies. When one item has to finish before another can start, the roadmap makes the knock-on effect of a delay visible.
  • It can support approval. Each item carries its business reason, owner and estimate, which makes the case for spending easier to review.
  • It cannot predict every failure. Equipment faults, security incidents and supplier changes still happen. Allow contingency, and when an unplanned cost appears, review the cause rather than treating it as proof the plan failed.

What should be in an IT roadmap?

A roadmap should hold enough detail to make decisions, and no more. Keep task-level schedules in the project plan and use the roadmap for the fields below.

Field What it records
Business outcome The result the business needs, such as a second site ready to trade.
Initiative The piece of technology work that supports the outcome.
Accountable owner The named person responsible for the result, not only the task.
Target period The quarter or month the work is planned for.
Dependency What must happen first, inside or outside IT.
One-off and ongoing cost A planning estimate for the change and for running it afterwards.
Decision or approval needed Who must approve what, and by when.
Success measure How you will know the outcome has been met.
Status Proposed, committed, later, paused or complete.
Next review date When the item will be checked again.

Separate committed work from proposed and later work. A future-year item can stay indicative until its assumptions and funding are confirmed, and any item can be paused, re-scoped or stopped if the expected benefit disappears or the costs change materially.

What does an IT roadmap look like in practice?

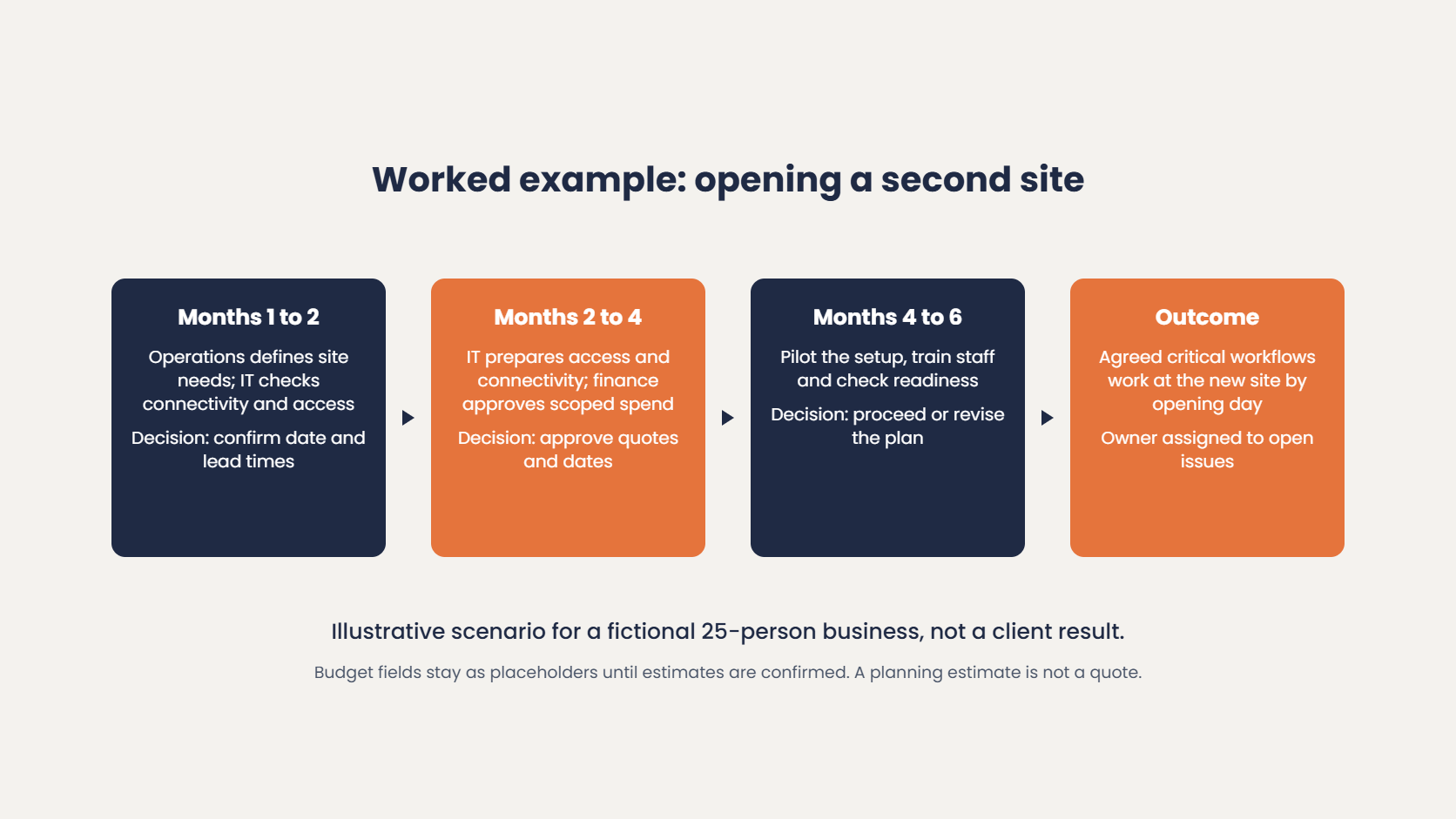

The example below is an illustrative scenario for a fictional business, not an Exodesk client result. The sequence is an example, not a delivery promise.

A 25-person business plans to open a second site in six months. The roadmap has to support that date without committing to equipment or a migration before the site requirements and connectivity are confirmed.

Stage Work and owner Dependency or decision
Months 1 to 2 Operations defines the site requirements; IT checks connectivity and system access. Confirm the opening date, site needs and supplier lead times before approving the design.
Months 2 to 4 IT prepares access and connectivity; finance approves the scoped spend. Approve quotes and confirm delivery dates before committing to dependent rollout work.
Months 4 to 6 Operations and IT pilot the setup, train staff and check readiness. Proceed only after the agreed access, calling and critical-workflow checks pass; otherwise revise the opening plan.

Budget fields for this item:

Field Example entry
One-off cost estimate Estimate to be confirmed after site requirements (state whether GST is included)
Ongoing cost change Estimate to be confirmed for connectivity, licences and support
Internal staff time Operations and IT hours to be agreed
Estimate date Date the estimate was prepared
Approval status Proposed, awaiting finance approval

A planning estimate is not a quote or a spending approval. It becomes firmer as the item moves closer and is scoped properly.

Success measure: staff at the new site can complete the agreed critical workflows by the opening date, with an owner assigned to any outstanding issues. Define those workflows and readiness checks before work starts, so the measure is more than “project completed”.

Illustrative IT roadmap for a fictional 25-person business opening a second site: site needs and connectivity in months 1 to 2, access and approved spend in months 2 to 4, pilot and readiness checks in months 4 to 6, with critical workflows working by opening day

A blank template you can copy

Copy these lines into a document or spreadsheet and fill in one set for each item on the roadmap.

Business outcome: [result needed]

Initiative: [work proposed]

Accountable owner: [name]

Target period: [month or quarter]

Dependency: [what must happen first]

Cost: [one-off, ongoing change and internal time]

Approval needed: [decision, person and date]

Success measure: [how the outcome will be checked]

Status: [proposed, committed, later, paused or complete]

Next review: [date]

How do you build an IT roadmap?

Building an IT roadmap runs in six steps, from agreeing outcomes to setting the first review date. Each step produces something the next one depends on.

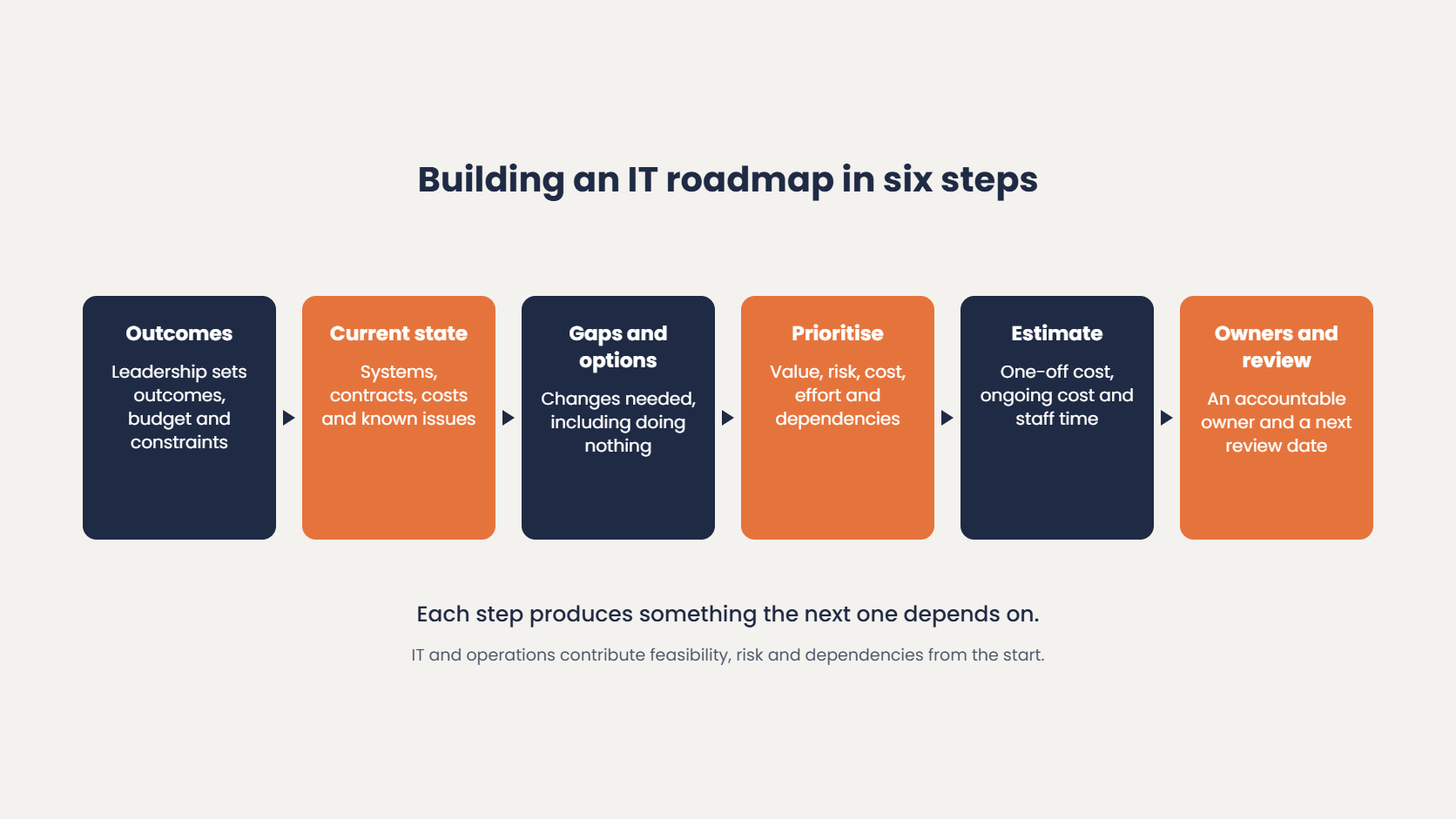

Building an IT roadmap in six steps: agree outcomes and constraints, assess the current state, identify gaps and options, prioritise and sequence, estimate costs and staff time, then assign owners and a review date

1

Agree the business outcomes and constraints

Leadership sets the outcomes, the budget envelope and the constraints, such as an opening date, a contract end or a compliance obligation. IT and operational staff contribute feasibility, risk and dependencies from the start, so the outcomes are ones the business can deliver.

2

Assess the current state

Record what is in place today: hardware ages, software and licences, cloud services, security controls, suppliers, contracts and known issues. A free IT assessment can provide a starting baseline for systems and security.

3

Identify the gaps and options

Compare the current state with the outcomes and list the changes needed to close the difference. For each gap, note the realistic options, including doing nothing, and what each one depends on.

4

Prioritise and sequence

Weigh each item by business value, risk, cost and effort, then order the work around its dependencies, staff capacity and supplier lead times. Some items must come first: network changes may need to precede a new phone system, for example.

Sequence security controls and training around the risks and dependencies involved. Explain changes before rollout and reinforce them afterwards. Urgent security work should not wait for the next roadmap phase.

5

Estimate costs and approvals

Give each item a planning estimate. For an initial comparison, use cost bands with agreed NZ-dollar ranges. Separate one-off and ongoing costs, include internal staff time, and confirm firmer estimates before approving spend. State whether estimates include GST, and add vendor end-of-life dates so replacements are funded before support ends. Where spreading cost matters, IT hardware leasing is one option to compare.

6

Assign owners and a review date

Give every item an accountable owner and a next review date, then agree how decisions will be recorded on the roadmap. Delivery is an agreed responsibility, whether it sits with your team, your IT provider or another supplier.

How far ahead should an IT roadmap plan?

One to three years is a useful planning range for an IT roadmap, with the detail concentrated in the near term. The next few quarters can carry firm owners, estimates and dates, while later items stay indicative until their assumptions are confirmed.

Align the plan with your own financial year, contract renewals, supplier lead times and busy periods. A retailer may avoid major changes before Christmas, while a business with a March year end may time approvals differently from one with a June year end.

How often should an IT roadmap be reviewed?

Quarterly review is a sensible starting point, with earlier changes when a major risk, deadline or business decision arises. Use the cadence needed to keep decisions current rather than a fixed rule.

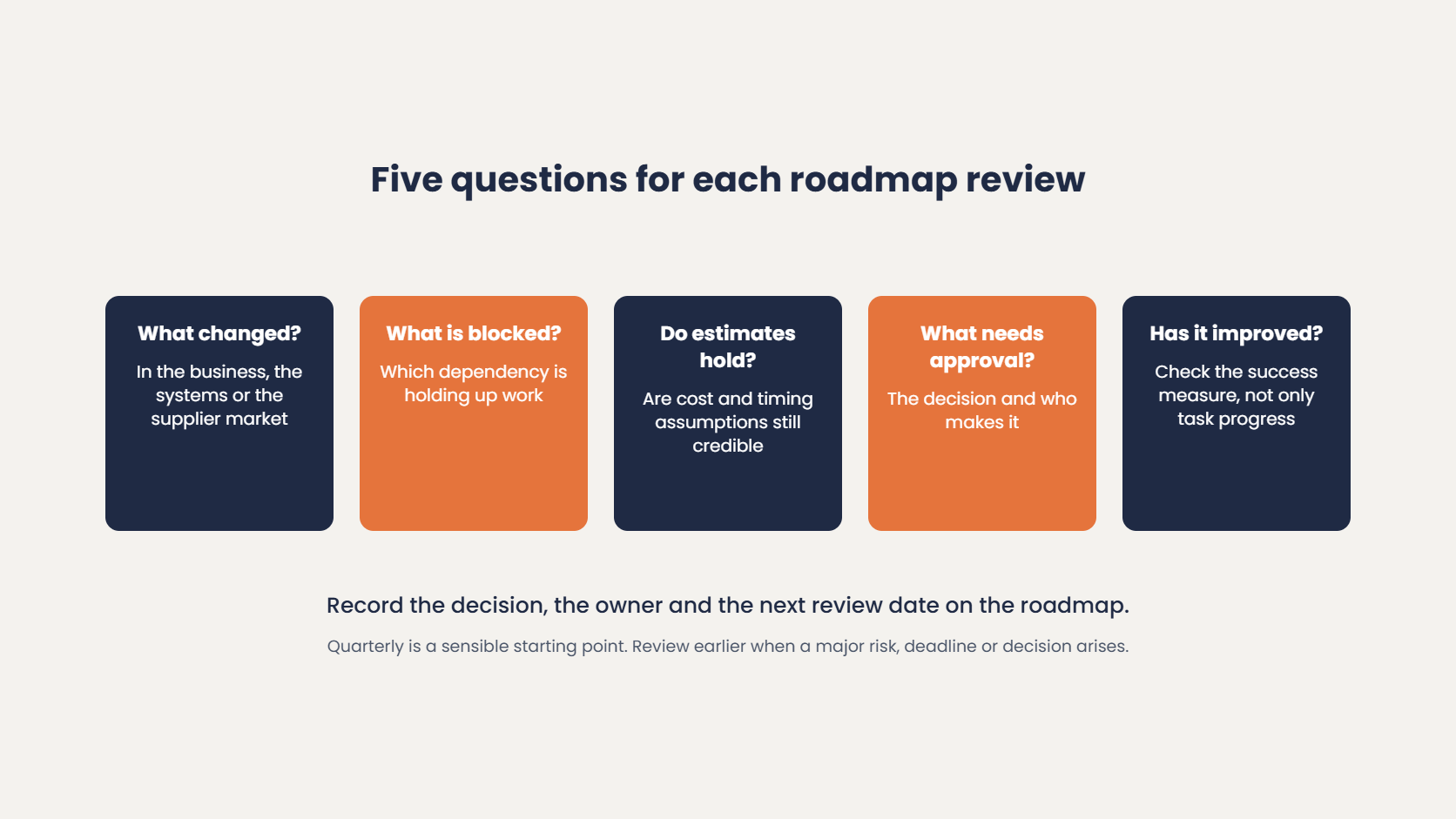

At each review, work through five questions:

  • What changed? In the business, the systems or the supplier market.
  • Which dependency is blocking work? And who can unblock it.
  • Are the cost and timing assumptions still credible? If not, re-estimate before committing more.
  • What needs approval? Name the decision and the person who makes it.
  • Has the intended outcome improved? Check the success measure, not only task progress.

Record the decision, the owner and the next review date on the roadmap itself. Events such as an acquisition and the integration that follows, a serious security incident or a major supplier change justify a review before the next scheduled one.

Five questions for each IT roadmap review: what changed, what is blocked, whether cost and timing estimates still hold, what needs approval and whether the outcome has improved

Who should own the IT roadmap?

The business owns the IT roadmap. A senior leader, such as the owner, general manager or operations manager, is accountable for keeping it current and approving changes, because the trade-offs affect commercial direction as well as technology.

An IT partner contributes options, costings, risks and delivery planning. A partner who challenges the plan when it needs challenging is more useful than one who agrees with every request.

How do you know whether the roadmap is working?

Judge each item against its success measure rather than against whether a project closed. Assess realised benefits against the planning, implementation and ongoing costs involved. Reduced risk is valuable, but an incident that did not happen is not a measurable cash saving, so record risk reduction separately.

Recovery targets are a good example. Before choosing one, define the business service, the acceptable downtime and data loss, the dependencies and the test conditions. Restoring a backup on its own may not restore the full business process, which is why recovery belongs in a tested disaster recovery plan.

IT roadmaps with Exodesk

Exodesk has supported businesses in Christchurch, Dunedin and across New Zealand since 1989. Through our IT consulting service, we review the systems and decisions in scope and turn the findings into prioritised recommendations and a roadmap with owners, dependencies and indicative budgets. Your business keeps ownership of the priorities and the decisions.

Frequently Asked Questions

What is an IT roadmap?

An IT roadmap turns business goals into a prioritised schedule of technology work. It shows what needs to change, why it matters, who owns it, what it may cost and which decisions must happen first.

What should an IT roadmap include?

Each item should record the business outcome, the initiative, an accountable owner, a target period, dependencies, one-off and ongoing costs, the decision or approval needed, a success measure, a status and the next review date. Keep detailed task schedules in the project plan rather than the roadmap.

Is a technology roadmap different from an IT roadmap?

The terms describe the same kind of plan and are used interchangeably. What matters is that the document connects business outcomes to owned, sequenced and costed work, whichever name you use.

What is the difference between an IT strategy and an IT roadmap?

An IT strategy sets direction, priorities and the principles for technology decisions. The roadmap turns that direction into a schedule of initiatives with owners, dependencies and costs. Strategy answers why and where, and the roadmap answers what, when and in what order.

Why does a business need an IT roadmap?

A roadmap makes known technology work visible early, so renewals, replacements and projects can be funded and scheduled before they become urgent. It also gives every spending request a reference point. It cannot predict every failure, so allow contingency as well.

How far ahead should an IT roadmap plan?

One to three years is a useful planning range, with the detail concentrated in the near term. Later items can stay indicative until their assumptions and funding are confirmed.

How does an IT roadmap relate to the annual IT budget?

The annual budget funds the part of the roadmap due in the coming financial year. The roadmap explains why each item is there and what depends on it, which makes budget decisions easier to test against agreed priorities.

How much does it cost to build an IT roadmap?

Cost depends on the size of the business, the decisions in scope and how much current-state information already exists. Ask for the scope, fee and deliverables to be agreed before work begins. Judge the value by the decisions the roadmap supports and the benefits realised, after planning and implementation costs.

How long does it take to build an IT roadmap?

Timing depends on the scope, the people involved and how quickly information about systems, contracts and costs can be gathered. A first version for the near term can come before the later years are worked out in detail.

Who should be involved in creating an IT roadmap?

A senior business leader should own it, with finance and operations involved in setting priorities. IT staff or an IT partner contribute options, risks, costings and dependencies from the start. The business makes the final decisions.

How often should an IT roadmap be reviewed?

Quarterly review is a sensible starting point, with earlier reviews when a major risk, deadline or business decision arises. At each review, check what changed, what is blocked, whether estimates still hold, what needs approval and whether the outcome has improved.

Can a small business benefit from an IT roadmap?

Yes. A short roadmap covering the next few quarters in detail and the following year in outline can bring order to renewals, replacements and projects. Keep it to the fields you will actually maintain.

NEXT STEP

Turn your priorities into a roadmap

Bring the decisions ahead, the dependencies you know about and the budget you are working to. Our teams in Christchurch and Dunedin work with businesses across New Zealand.

Or see our IT consulting service.
